Skip to main content
Stop executive stalls: two-slide trade-off visuals, speaking notes and decision scripts for fast funding reallocation

Stop executive stalls: two-slide trade-off visuals, speaking notes and decision scripts for fast funding reallocation

How to get a steering committee to move money in one meeting instead of three

The reallocation was already approved on paper: the scoring model recommended pulling $180k from a loyalty rebuild into a schedule‑bleeding fraud workstream, and Finance had signed off on the mechanics. Still, the decision died in the room when someone asked, “what's the actual downside if we don't?” and nobody had a single-view answer. The meeting ended with “let's take it offline.” Two weeks later the fraud team was still under-resourced and the loyalty rebuild had burned another sprint on work likely to be de‑prioritized without clear direction from the committee. This gap — between a decision that's technically ready and one the room can actually make — is almost always a presentation problem, not an analysis problem. Executive trade-off visuals are a tight fix for that presentation gap. This post focuses on one thing: a two-slide pattern that turns a stalled reallocation into a yes-or-no in a single sitting, plus the speaking notes and decision scripts to run it.

Everything else lives in the appendix for people who want to dig. The two slides control the cognitive load in the room so the committee can see the trade-off shape fast enough to decide.

Why reallocation decisions stall even when the numbers are done

Most reallocation decks are written for the analyst, not the approver: they show the model, the scoring, and many cost columns, and then assume the executive will synthesize it in real time while the room watches. That expectation creates deferrals, not decisions.

Executives don't stall because they lack data. They stall because they can't see the shape of the trade-off fast enough to feel safe committing. The safe move is deferral — it costs them nothing personally, while an approval they don't understand costs credibility.

  1. What does this cost us if we're wrong?
  2. Which projects are we actually starving to feed this one?
  3. Is this reversible?

If your slides don't answer those three questions in about ninety seconds, the executive's default is to defer. Heavier, more thorough decks generate more questions and more offline reviews — density reads as unfinished thinking even when the analysis is sound.

The two-slide pattern: impact vs cost, then risk vs reward

The pattern is deliberately small: two slides only. Everything else goes into the appendix. Each slide answers a single approver question so the room can decide quickly.

Slide one — Impact vs Cost: a scatter or quadrant view plotting each candidate project's outcome contribution against the incremental cost to complete. The reallocation shows up as arrows: money leaving low‑impact/high‑cost projects and arriving at higher‑impact/lower‑cost ones. The executive reads direction and logic in one glance.

Slide two — Risk vs Reward: the same candidates, different axes. Reward (expected benefit or confidence in benefit) versus composite delivery/dependency risk. This slide answers “what if we're wrong.” High‑reward/high‑risk moves require different controls than high‑reward/low‑risk ones. Showing both slides back‑to‑back demonstrates you've already considered failure cases.

Why two slides works: you're separating the two mental questions an approver asks — “Is this worth it?” and “Can this hurt me?” Each slide has one job. Mash them together and you create confusion; split them and the room can focus on the decision.

What goes on each axis (and what to leave off)

SlideX-axisY-axisBubble size / colorWhat NOT to add
Impact vs CostCost to complete (or incremental spend)Strategic impact / outcome contributionConfidence in the estimateTimeline, RAG status, owner names
Risk vs RewardDelivery + dependency risk (composite)Expected reward / benefitReversibility (color: green = reversible, red = one-way door)Sprint velocity, resource counts, historical spend

Resist the temptation to encode more dimensions. Every extra variable is one more thing the executive must decode before deciding. Bubble size and color are the only extras that consistently help because they answer the top follow-ups — “how sure are you?” and “can we undo this?” — without a new chart.

Standardizing plot metrics with the pack builder

To keep visuals objective across initiatives, PMOs need consistent math before plotting. You can use our Download the Two‑Slide Pack Builder (XLSX) to normalize metrics and generate presentation-ready values. This aligns with portfolio governance guidance such as the UK government teal book.

  1. Impact normalization formulas

    map disparate metrics to a uniform scale relative to portfolio goals

  2. Composite risk

    combine delivery risk and cross-team dependency exposure into one horizontal coordinate

  3. Reversibility flag

    mark moves that can be paused or unwound without contractual penalty

  4. Bubble sizing

    scale bubble diameter to estimation confidence so high‑certainty items stand out

When formatting slides, ensure color cues meet WCAG contrast guidelines and pair colors with distinct shapes or labels for color‑blind readers.

Formula: Composite Risk Score = (Delivery Risk Score + Dependency Risk Score) ÷ 2

In plain English: this averages internal delivery risk and external dependency risk into a single coordinate for the Risk vs Reward slide.

Example: delivery risk 4 and external dependency 2 → composite risk = 3.

What it means: initiatives with higher composite risk should have explicit milestone gates and pre‑agreed unwind triggers before funds are released.

Synthetic worked example (illustrative). Always verify ledger accounts and transfer mechanics with Finance — treat the workbook's decision record format as an operational checklist, not an accounting document.

The speaking notes that carry the slides

A trade-off visual without narration invites room interpretation, which is where meetings go sideways. Speaking notes steer the conversation; they do not explain the methodology. Keep the narration short and action-focused.

  1. Name the move in one sentence (e.g., “We're recommending moving $180k from loyalty‑rebuild to fraud‑detection this quarter.”)
  2. Point to the arrow, not the data (show direction and logic visually).
  3. Pre‑empt the top objection (e.g., “yes, loyalty still ships, just a quarter later”).
  4. Hand off to slide two (explain the next slide is the ‘what if we're wrong’ view).

Four short beats. Do not lead with methodology; put that in the appendix. Methodology in the main narrative signals lack of confidence in the recommendation.

  1. This project is high‑reward and reversible — if it doesn't pan out in a quarter, we stop and reclaim remaining funds.
  2. The project we're pausing is low‑risk to pause; we're not creating a new problem.
  3. Downside

    we lose a quarter of loyalty progress. Upside: we stop the fraud bleed before it becomes reportable.

Reversibility framing is underused. Executives approve reversible decisions faster because a reversible decision is cheap to be wrong about. If the move can be unwound, say so aloud and color it green on the slide.

The decision script: getting to yes or no before the meeting ends

The visuals get you to the decision moment; the decision script gets you through it. A short, pre‑written set of prompts forces a clean outcome instead of drifting to “let's think about it.” Run this after slide two.

  1. The direct ask

    “I'm asking for approval to move the $180k this week. Can I get a yes or a no today?”

  2. The conditional branch

    “If it's not a full yes — what's the one thing you'd need to see to make it a yes?”

  3. The parking‑lot cap

    “If we need more analysis, let's name exactly what and set a decision date now — not 'offline.'”

Forcing a decision date keeps the reallocation alive. The conditional branch usually surfaces a single missing piece you can often answer from the appendix; if not, it gives you a focused follow‑up to deliver by the named date.

When this two-slide approach actually makes sense

  1. You're moving money between existing funded projects, not proposing net‑new funding.
  2. The steering committee is time‑boxed and over‑scheduled.
  3. You have a history of decks that generate more questions than answers.

If the analysis is genuinely decision‑ready and the bottleneck is the room, this pattern accelerates outcomes without sacrificing rigor.

When it's a bad idea

  1. The prioritization scoring is contested — if the room doesn't trust how impact was scored, fix the scoring conversation first.
  2. The decision is a genuine one‑way door with regulatory or contractual implications — those need the full pack and a slower cadence.
  3. You're using visuals to paper over a recommendation you're not confident in — a clean quadrant makes confidence gaps more obvious, not less.

If scoring trust is the issue, do the work to link prioritization scores to funding slices before building trade‑off visuals.

Who should not run this

If you don't own the reallocation recommendation — if you're presenting someone else's numbers you cannot fully defend — don't run the decision script. The direct ask only works when you can handle follow‑ups without deferring; running it from shaky ownership exposes that gap publicly.

A real scenario: fintech PMO, quarterly steering committee

A mid‑size fintech PMO with ~40 active projects kept losing reallocations to the same pattern. Their standard funding‑move deck ran 18–22 slides, and time from “recommendation ready” to money moved averaged nearly three weeks because reallocations bounced through several meetings.

They rebuilt a fraud‑vs‑loyalty reallocation into the two‑slide pattern with speaking notes and a decision script; the appendix retained all old detail. The reallocation cleared in a single 20‑minute agenda slot with one clarifying question answered live from appendix slide 11.

Over two quarters, about a dozen reallocations run this way resolved mostly in one meeting instead of 2–3. ‘Take it offline with no date’ dropped markedly. An added side effect: the appendix got better — teams stopped padding the front deck and curated appendix content to answer the top three objections in order.

How the two slides connect to your regular governance rhythm

These trade‑off visuals aren't standalone artifacts — they pull from the health signals you already track. Impact‑vs‑cost uses cost‑to‑complete and outcome data; risk‑vs‑reward uses delivery‑risk and benefits‑confidence signals.

If you run a tight portfolio review, the two slides are a decision‑focused cut of the same underlying data you already gather. The end‑to‑end workflow looks roughly like this:

  1. Health review surfaces underperforming or starved projects
  2. Identify reallocation candidate pairs
  3. Pull impact, cost, risk and reward data into the two quadrant templates
  4. Draft the four‑beat speaking notes and the decision script
  5. Pre‑position the top three likely objections in the appendix
  6. Get 20 minutes on the steering agenda and run it

If the data already flows from regular reporting, building the two slides is closer to an hour than a day, making the format sustainable every cycle rather than occasional.

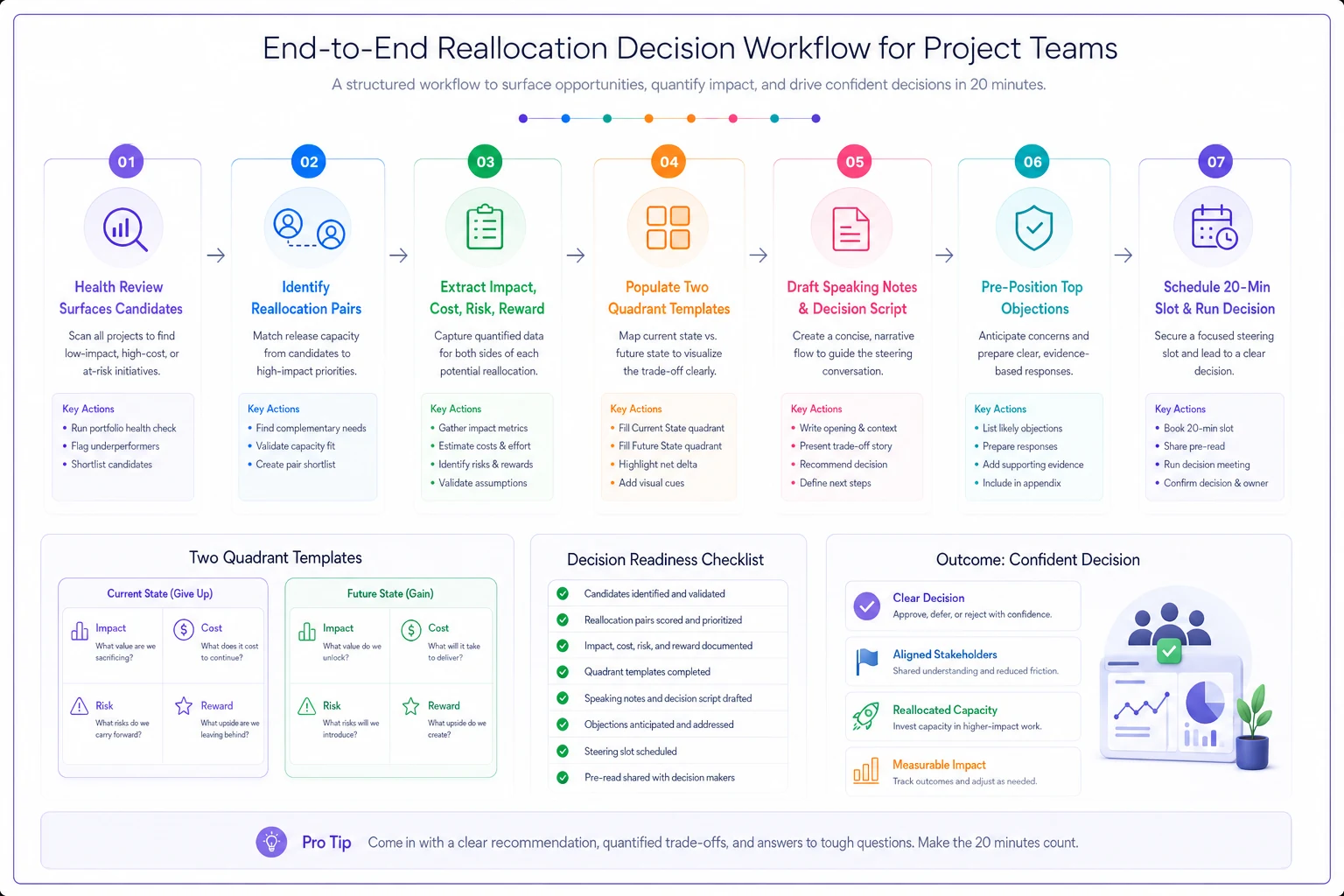

Process diagram

The one habit that makes all of this stick

Build a reusable template for both slides — fixed axes, fixed color coding for reversibility, and fixed bubble‑size meaning — and don't redesign it every cycle. The value compounds when executives recognize the format: by the third exposure they already know how to read it and the comprehension window shrinks.

Standardization also raises the bar for recommendations. When the format is consistent, weak recommendations become obvious and the template becomes a forcing function for better analysis, not just better presentation.

Reallocation speed isn't about producing more analysis than the room can absorb. It's about presenting exactly enough for the room to see the shape of the trade‑off, feel confident the downside is contained, and say yes before the meeting runs out: two slides, four spoken beats, one direct ask. Everything else belongs in the appendix, ready but out of the way.

If you want a reusable workbook to normalize impact, compute composite risk, size bubbles, and generate speaker notes plus a decision checklist, download the Two‑Slide Pack Builder to accelerate repeatable, decision‑ready reallocations.
